Construction Update - April 2026

Since our last update, crews have nearly completed work on the project laydown yard on State Route 4, including the delivery of job trailers and the installation of safety fencing. Crews have also been inspecting the full linear facilities route of the project, including locations of all turbines, access roads, underground collection corridors, and crane paths.
Other key construction activities since our last construction update include:
  • Completion of the limited tree clearing needed for access road installation and facility placement.
  • Approximately 30% of access road entrances from local roadways have been installed.
  • Signage installed for routes covered by local road use agreements, ensuring construction traffic uses the designated routes.
  • Ongoing material and equipment deliveries

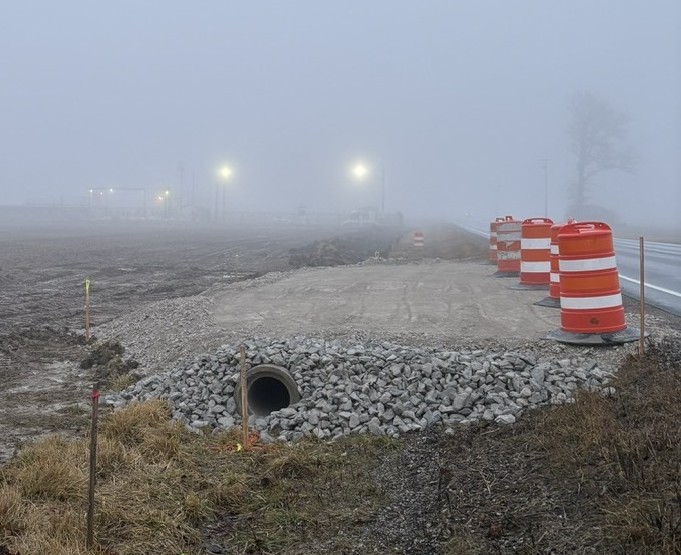

Access Road entrance installation

Looking ahead, activities anticipated to take place over the next month include:

  • Continued access road installation working from the South to the North
  • Site preparation for project substation and GE welcome center, where trucks carrying wind turbine components can check in prior to final delivery to turbine locations.
  • Turbine Foundation excavation
Long-term, our anticipated construction schedule is as follows (subject to change):
  • Spring 2026
    • Access roads (April/May)
    • Road Widening/Surface Upgrades(May/June)
    • Turbine Foundation Excavations (May)
    • Start of Substation construction (May)
  • Summer 2026
    • Foundation Rebar Install/Concrete Pour (June)
    • Collection line trenching/installation (June) .
    • Transmission Line Construction (August)
    • Component deliveries begin (August)
  • Fall 2026
    • Turbine deliveries
    • Tower installation
  • Spring 2027
    • Turbine commissioning
    • Project Energization (May 2027)
  • Summer/Fall 2027
    • Site restoration (June 2027)
    • Commencement of operations (July 2027)
